A contributor for Eano and industry software expert in SaaS and construction technology, John helps share tech tips with construction professionals for practical application. His background in product management and marketing gives him a unique perspective on how technology can solve real-world challenges in the construction and trades industries.

ADU Garage Conversion Cost & Estimating Guide for Contractors (California / LA)

Oct 20, 2026
•
11
min read
A contractor's guide to pricing garage-to-ADU conversions in California: 2021 survey cost data, the hidden cost drivers to check on site, the state fee and parking rules, LA County's streamlined six-step permit path, and an itemized sample estimate.

A garage-to-ADU conversion looks like the cheapest way to add a rental unit, and statewide survey data says it usually is. But the price a homeowner sees depends on things you can only find on site: the condition of the slab, how far the sewer is, whether the panel can take another unit, and how the fire separation has to work. This guide walks contractors through what drives a garage conversion price in California, how the fee and parking rules change the math, how LA County's streamlined permit path works, and how to itemize the estimate so homeowners say yes.

If you want the bigger picture on accessory dwelling units first, start with our complete guide to building an ADU. To see a finished example, open the sample garage conversion proposal.

Key takeaways

  • Garage conversions are the lowest-cost ADU type in the best statewide data we have. In a 2021 UC Berkeley Terner Center survey, garage ADUs had a median construction cost of $90,000 ($189.19 per sq ft), compared with $150,000 ($250 per sq ft) for all ADUs.
  • Units of 750 sq ft or less don't pay impact fees under state law, and the city can't make the owner replace the parking lost when the garage is converted.
  • LA County has a streamlined path for garage conversions that uses standard notes and details instead of custom structural plans, if the project meets the eligibility list.
  • The estimate is where you win or lose the job. Itemize the hidden scope (slab, moisture, egress, utilities, Title 24, fire separation) so the homeowner understands why your number is what it is.

What a garage-to-ADU conversion actually includes

A garage conversion turns an existing garage into a separate, legal living unit with its own entrance, kitchen, bathroom and sleeping area. It is different from a new detached ADU because you are working with an existing slab, existing walls and an existing roof. That is why it is usually cheaper, and also why it carries more unknowns: you inherit whatever the original builder did, plus any unpermitted work done since.

LA County Public Works describes its program as "adaptive reuse of existing garages into new accessory dwelling units through an expedited permit processing using standardized sheets, pre-construction meetings, and construction guide" (LA County Building & Safety). To qualify for that streamlined path, the County lists conditions including:

  • The ADU is converted from an existing single garage or storage building
  • "Less than 1200 SF for ADU and Less than 500 SF for JADU"
  • "NO additional footprint area will be constructed"
  • "NO complete demolition of existing structure" and no re-building of the existing structure
  • No unpermitted construction within the building
  • No additional roof loading greater than 5% of the existing, and single-story only
  • A mandatory pre-construction meeting with the County building inspector

Those rules matter for your scope. If the homeowner wants to push a wall out, add a second story, or tear the garage down and rebuild it, the project falls outside the streamlined program and you are back to a custom plan set with structural calculations. Ask about that in the first site visit, because it changes the schedule, the design fees and the price.

Modern detached ADU with large windows built behind a single-family home in California
A finished ADU. Garage conversions reuse the slab, walls and roof, which is where both the savings and the surprises come from.

What garage conversions cost: the survey data vs. what drives your number

The most widely cited statewide dataset is the Terner Center and California Community Investment survey of ADU owners, published in 2021 as Implementing the Backyard Revolution (PDF; summary). Treat these as 2021 survey figures, not current prices. Materials and labor have moved since then, so they are a sanity check, not a bid.

ADU type (2021 survey)Median construction costMedian cost per sq ft
Garage conversion ADUs$90,000$189.19
All ADUs, statewide$150,000$250.00
All ADUs, Los Angeles Countyn/a$223.04

The survey also found that Los Angeles County ADUs "have a lower median cost per square foot ($223.04) than the state median ($250)," and that garage conversions "accounted for 39% of total ADUs built" in LA County. It notes that garage conversions "are the cheapest to build statewide both in terms of overall construction cost and cost per square foot."

That is the headline. Your actual number depends on the cost drivers below. These are the line items that separate a $90,000 garage conversion from one that costs far more, and they are the ones homeowners don't see coming.

Cost driverWhat to check on siteWhy it moves the price
Slab and vapor barrierSlab level, cracks, slope toward the garage door, moistureGarage slabs often slope to drain and may lack a vapor barrier. Leveling, a new topping slab or a sleeper floor adds labor and height.
Insulation and Title 24 energy complianceWall cavity depth, ceiling space, existing windowsA garage was never built as conditioned space. LA County's submittal requires Title 24 energy sheets and calculations.
Garage door infill and egress windowsDoor opening size, header, bedroom locationThe door opening becomes a framed wall with windows or a door. Sleeping rooms need code-compliant egress openings.
Plumbing to sewerDistance and fall to the main line, cleanout locationTrenching through slab and yard to tie in a kitchen and bathroom is often the biggest single unknown.
Electrical serviceMain panel capacity, distance, sub-panel needA kitchen, HVAC and water heater can push the existing service past its limit.
HVACWall space, outdoor unit locationDuctless mini-splits are common in conversions because there is no attic or duct chase.
Fire separationDistance to the main house and property linesAttached garages and close setbacks can trigger rated assemblies. Confirm with the plan checker.
Fees and designPlan set, Title 24, permit fees, utility feesImpact fees are waived at 750 sq ft or less (see below), but plan check, permit and utility connection fees still apply.

Each of those rows should be its own line or section in your estimate. If you lump them into one number, you have nothing to point to when the homeowner compares you with a cheaper bid that left the sewer trench out. Our guide to job costing for residential contractors shows how to track these same lines against actuals once the job starts, so your next conversion bid is based on what the last one really cost.

Fees and parking: the 750 sq ft rule and the no-replacement-parking rule

Two state rules in the California Department of Housing and Community Development (HCD) ADU Handbook directly affect the price and the pitch for a garage conversion.

Impact fees

HCD says an ADU "is exempt from incurring impact fees from local agencies, special districts, and water corporations if it contains 750 square feet of interior livable space or less." Above 750 sq ft, impact fees "shall be charged proportionately in relation to the square footage of the ADU to the square footage of the primary dwelling unit." A typical one- or two-car garage falls well under 750 sq ft, so most garage conversions avoid impact fees entirely. Plan check, permit and utility fees are separate, so keep a fees line in your estimate anyway.

Replacement parking

Homeowners often assume they will have to build a new parking space to replace the garage. They don't. HCD states that "a local agency may not require off-street parking spaces to be replaced when a garage, carport, covered parking structure, or uncovered parking space is demolished in conjunction with the construction of an ADU or converted to an ADU (Gov. Code, § 66314, subd. (d)(11))."

Put that in your proposal in plain English. It removes a cost the homeowner may have mentally added to the project, and it shows you know the rules.

LA County's streamlined garage-conversion permit path (6 steps)

For projects in unincorporated LA County, Public Works lays out six steps for a garage conversion (source). Cities inside the county, including the City of Los Angeles, run their own building departments, so confirm the jurisdiction before you promise a timeline.

StepWhat happensWhat it means for your schedule
1. Regional Planning approvalSubmit architectural plans to Regional Planning and get approval.Design must be done before anything else moves. Build this into your pre-construction phase.
2. ScreeningOpen an application via EPIC-LA or at the district office with the approved plans; get an Agency Referral Sheet.Agency referrals (for example fire or public works) can add review steps.
3. Plan recheck and approvalResubmit with the Standard Notes and Details, Title 24 energy sheets and calculations, and completed agency referral items.Title 24 work has to be done here, not after you start.
4. Permit issuancePay permitting fees, obtain combination permits, schedule the pre-construction meeting.Fees are paid at this point; make sure they are in your payment schedule.
5. Pre-construction meetingMeet the County building inspector before construction.Mandatory. Bring your superintendent and the homeowner.
6. Construction and inspectionBuild and pass inspections.Use the County's conversion inspection checklist to plan your inspection sequence.

The County also states that an existing garage conversion to an ADU (attached or detached) does not require structural plans and calculations when you use its Standard Notes and Details. A conversion with new additions does. That single choice, convert in place or add on, is one of the biggest swings in design cost and permit time, so price both options if the homeowner is undecided.

How to estimate a garage conversion line by line: a sample estimate

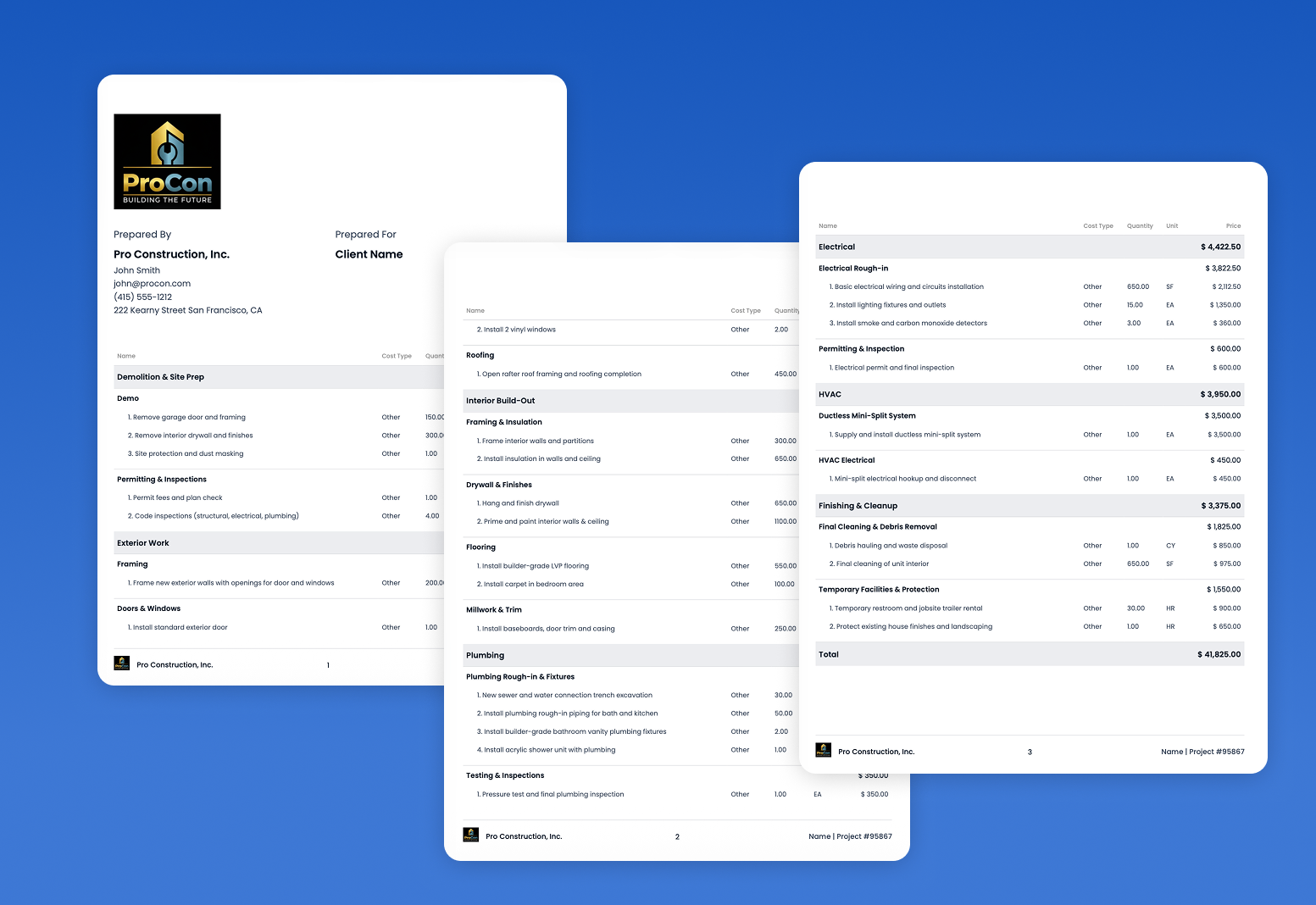

Below is the structure of an itemized estimate for a 400 sq ft single-car garage conversion, converted in place under a streamlined program. The dollar amounts are illustrative only, not a quote and not a market price. They are there to show how the pieces add up. Replace every number with your own costs, sub bids and markup. For a ready-made layout, use our free contractor estimate template, or compare with the live garage conversion sample proposal and the broader ADU sample proposal.

SectionScope includedUnitQtyIllustrative cost
Design and permitsPlan set, Title 24 calcs, plan check and permit feesLS1$9,000
Demolition and prepRemove garage door, shelving, non-structural items; protect siteLS1$3,000
Slab and moistureGrind high spots, vapor barrier, self-leveling or sleeper floorSF400$6,000
FramingInfill garage door opening, interior walls, window and door openingsLS1$9,000
Windows and exterior doorEgress windows, entry door, flashingEA5$7,500
PlumbingTrench to sewer, kitchen and bath rough-in, water heaterLS1$15,000
ElectricalSub-panel, circuits, lighting, smoke/CO alarmsLS1$9,500
HVACDuctless mini-split systemLS1$6,500
Insulation and drywallWalls and ceiling insulation per Title 24; drywall, tape, textureSF1,200$9,000
KitchenCabinets, countertop, appliances allowanceLS1$12,000
BathroomShower, toilet, vanity, tileLS1$11,000
FinishesFlooring, paint, doors, trimSF400$8,500
Subtotal (direct cost)$106,000

Three things make this structure work. First, every hidden-cost driver from the table above has its own line, so the homeowner can see where the money goes. Second, allowances (appliances, tile, fixtures) are labeled as allowances, which sets up clean change orders if the homeowner upgrades. Third, the sections match the way you will schedule and job-cost the work, so the estimate becomes your budget instead of a document you never look at again.

From there, add overhead and profit. If you are not sure whether your markup actually covers overhead, run your numbers through our free profit margin calculator before you send the price.

Presenting the price: itemized vs. lump sum

Some homeowners want one number. Others, especially those working with a lender, an HOA or a co-owner, want to see every line. The safest approach is to build the estimate itemized and then choose how much detail to show. TG Renovation, a Los Angeles contractor focused on ADUs and remodels, put it this way:

"Sending out a quote and an estimate super professional, being able to either itemize it or leave it more of a general number — that is very helpful for clients." — TG Renovation

On one bid, that detail was what got the job approved:

"That's what helped, because they wanted to see that level of detail for their board to accept the bid." — TG Renovation
"If you're not able to really present that in a professional way — you're losing bids." — TG Renovation

With Eano Pro estimates, you build the itemized version once and decide what the client sees on the proposal, so you are not maintaining two documents.

Common change orders on garage ADUs, and how to write them in before they happen

Garage conversions generate change orders because you are opening up an existing building. The fix is not to avoid them; it is to name them in the contract with a clear process and, where you can, a unit price. Common ones include:

  • Slab moisture or cracking worse than visible at the site walk. Write in a per-square-foot price for additional leveling or moisture mitigation.
  • Sewer tie-in farther, deeper or in worse condition than expected. Carry an allowance and a per-foot rate for additional trenching.
  • Electrical service upgrade required by the utility or plan checker. Exclude it from the base price or carry an allowance.
  • Unpermitted prior work discovered during demolition. LA County's streamlined program excludes buildings with unpermitted construction, so flag this early.
  • Finish upgrades beyond the allowance for cabinets, tile or fixtures.

Whatever the change, get it in writing and signed before the work happens. In California, CSLB requires that changes to the contract price or scope of a home improvement contract be made with a written change order signed by both parties. Eano Pro's change order software lets the homeowner review and e-sign the change from their phone, and it updates the job budget automatically.

Bottom line

Garage conversions are the most affordable ADU type in the best statewide data available, and California law removes two of the biggest cost objections: impact fees on units of 750 sq ft or less, and replacement parking. What separates a profitable conversion from a painful one is the estimate. Walk the site for the hidden scope, itemize it, show the homeowner why the number is what it is, and write the likely change orders into the contract before you start.

Build your next garage-ADU estimate in Eano Pro. Start a free trial

Get a Personalized Demo

See how Eano Pro can streamline your contracting workflow.

FAQs

How much does it cost to convert a garage into an ADU in California?

In a 2021 UC Berkeley Terner Center survey of California ADU owners, garage conversion ADUs had a median construction cost of $90,000 ($189.19 per sq ft), compared with $150,000 for all ADUs. Costs have changed since 2021, and the real price depends on the slab, utilities, egress, energy compliance and fees, so get an itemized estimate.

Do I need to replace the parking when converting a garage to an ADU?

No. According to California HCD's ADU Handbook, a local agency may not require off-street parking spaces to be replaced when a garage is demolished or converted to an ADU (Gov. Code, § 66314, subd. (d)(11)).

Are impact fees charged on a garage ADU?

Not if the ADU has 750 square feet of interior livable space or less. Above that, HCD says impact fees are charged proportionately to the size of the primary home. Plan check, permit and utility fees still apply.

How long does a garage ADU permit take in LA County?

LA County does not publish a fixed timeline. Its streamlined garage conversion program has six steps: Regional Planning approval, screening, plan recheck and approval, permit issuance, a pre-construction meeting and construction with inspections. Using the County's standard notes and details avoids custom structural plans for eligible conversions.

What's the difference between an ADU and a JADU garage conversion?

A JADU is no more than 500 square feet and is contained entirely within a single-family home, per California HCD. A garage conversion is usually an ADU. LA County's streamlined program allows ADUs under 1,200 sq ft and JADUs under 500 sq ft.

Recent posts

AI Takeoffs

Free Test Drive of AI Takeoffs

Upload your drawings and plans and get an estimate in your inbox!
STEP 1/6 Upload your plans

Drop a blueprint here

PDF, elevations, or architectural plans · up to 100MB

    You're all set

    Most itemized estimates are ready within 15 minutes. Check spam if you don't see it land.

    To restart the chat, refresh the page. Your files are used only to generate this estimate.
